Interfaces on large projects: installer, manufacturer and maintenance team at one table

By Tobias Schott  · 23-minute read · Updated October 2026

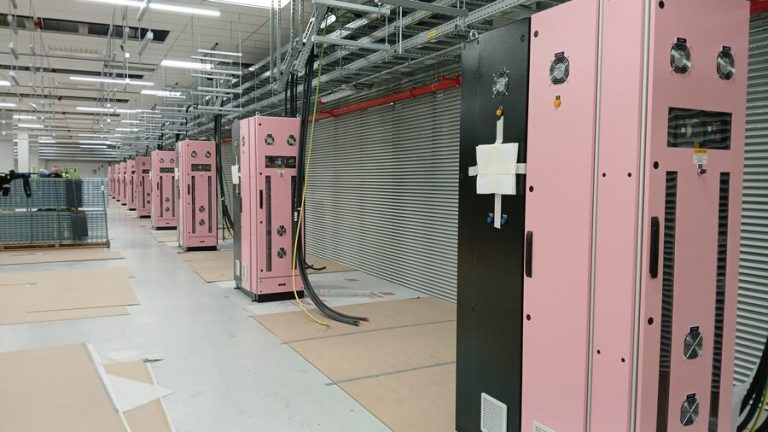

Aligned and ready for electrical connection
The interface in one picture: the distribution cabinet stands laser-surveyed in its position – from here the electrical trade takes over.

Most delays and variations in installation work on large projects do not arise at the plant but at the interfaces. Where nobody has defined where one trade ends and the next begins.

A data center with eight data halls, a production line with a steel platform, a suppression cylinder room with 240 cylinders: large projects bring manufacturers, specialist contractors, subcontractors, designers and site management onto one site. Each supplies a part of the whole. Interfaces in large installation projects are the points at which these parts have to come together – spatially, in time and technically. Those who do not clarify it beforehand clarify it on installation day, under time pressure, with a following trade that is waiting.

This article builds on our guide to the scope of works for plant installation. That guide is about tendering an installation service so that no variations arise. This one is about what lies between the services. And about how to set up an interface list, a responsibility matrix and clean handover points that work on site.

We write from the perspective of the installation contractor, which in large projects usually works as a subcontractor to a manufacturer, a specialist contractor or a general contractor. At the end it hands the plant over to the future maintenance team. Three projects from our project diary show what this looks like: 160 power distribution cabinets in a data center in the Rhine-Main region, a gas suppression system in the Frankfurt area and a steel platform at Kassel Airport.

Key points at a glance

What are interfaces in large installation projects?

Explanatory graphic: interfaces in large installation projects – the spatial, temporal and technical dimension of each interface with examples from installation, electrical work and commissioning.
Interfaces have three dimensions – and most variations arise where only one of them was clarified. Graphic: Omega Mounting

Interfaces in large projects are the transitions between the services of different parties, at which one trade hands over a result on which the next one builds. The parties are the client, designers, general contractor, manufacturers, specialist contractors, subcontractors and the future operator. In installation work these are typically the transitions between construction and technology, between delivery and placement, between placement and connection, and between connection and commissioning.

The term trade denotes a defined service with its own expertise – steelwork, electrical, refrigeration, fire protection, installation. Separation of trades is normal and sensible in large projects, because everyone does what they do best. It only works if every dividing line is defined as an interface: preceding trade, following trade, handover point, verification.

Three dimensions of every interface

Most conflicts arise when only one dimension has been clarified. For instance the spatial one (“up to the flange”), but not the temporal one (“when is the building network depressurised?”) or the technical one (“who tests for tightness?”).

Why large projects are particularly vulnerable

The more parties, the more interfaces. Their number grows faster than the number of parties. Added to this in large projects are takt planning, parallel trades on the same area and bottlenecks such as a single heavy-duty lift. And chains of responsibility across three contract levels: client – general contractor – manufacturer – installation contractor. What the client agreed with the general contractor often reaches the installation contractor only as “by others”.

Which interfaces exist in installation work on large projects?

Overview: interfaces in large installation projects – interface list with preceding trade, following trade, handover point and verification from foundation to handover to the operator.
Eight points at which one trade hands over and the next builds on it in installation work – each interface with handover point and verification. Graphic: Omega Mounting

In installation work on large projects, interfaces occur at eight points. These are construction and foundation, installation route and lifting gear, delivery and packaging, placement and surveying. Plus utilities and electrical, safety devices, commissioning, and documentation and handover to the operator. The following interface list shows them with preceding trade, following trade, handover point and verification.

InterfacePreceding trade (supplies)Following trade (builds on it)Handover pointRecord
Foundation, floor, load-bearing capacityShell construction, structural engineerInstallation contractorFoundation accepted, imposed load and point loads approved, floor covering acceptedConstruction acceptance report, structural engineer's load data
Installation route and lifting gearSite management (by others), crane contractorInstallation contractorCrane standing area load-bearing, installation opening clear, heavy-duty lift approved, transport routes cleared.Completion notice from site management, lift plan, crane pre-use inspection
Delivery and packagingManufacturer, haulage companyInstallation contractorDelivery with unloading point, weight data, lifting points, parts listDelivery note, packing list, transport damage report
Placement and surveyingDesigner (axis grid, target position)Installation contractor → following tradeSet-down positions laser-surveyed and marked, plant aligned and fixedSurvey report, installation report with photos
Utilities and electricalInstallation contractorElectrical, refrigeration, pipework contractorsPlant positioned, connection points accessible, handover flange or terminal box definedInstallation completion notice, interface drawing
Safety devicesInstallation contractor, manufacturerOperator, specialist contractorRailings, fall protection, emergency stop, interlocks installed and testedTest report, manufacturer's declaration
CommissioningInstallation contractorManufacturer or specialist contractorMechanically complete, tight, fixed, torque-checkedInstallation report, tightness test, torque record
Documentation and handoverAll tradesOperator, maintenance teamDocumentation package complete, snagging list worked off, briefing givenHandover report, as-built documents, spare parts list

“By others” – the most dangerous words in the contract

Technical drawing of an interface list with client-side services – site power, crane, lift, isolation, access – each with date, person responsible and release notice; a missing lift release leaves the team waiting and leads to a notice of obstruction
Every client-side service needs its own line with date, person responsible and a release notice before installation day – otherwise the team waits and files a notice of obstruction. Graphic: Omega Mounting

“By others” (German: bauseits) means: the client provides something the contractor needs for its service – power, crane, lift, scaffolding, access, isolation, utility connection. The words are short, the consequences are long. If the client-side provision is not there on installation day, the team stands idle. The installation contractor must then issue a notice of obstruction – the written notification that it cannot perform its service because a prerequisite is missing. Every client-side provision therefore belongs in the interface list with date, responsible person and completion notice. Not just with the words “by others” in the scope of works.

Recognising the bottleneck

Technical drawing comparing an unscheduled lift where three trades queue on the same morning with a lift managed by a booking plan with a person responsible
One lift, one installation opening, one crane standing area – a bottleneck gets its own line with a booking plan and a person responsible. Graphic: Omega Mounting

In every large project there are bottlenecks that several trades need at the same time: the one heavy-duty lift, the one installation opening, the one crane standing area, the one access gate. These bottlenecks are interfaces of a special kind because they have to be scheduled. Give them their own row in the interface list, with an occupancy schedule and a responsible person, and you avoid one thing: three trades standing in front of the same lift on the same morning.

The laser-surveyed hall with marked set-down positions
Marking lines on the floor protection: the set-down positions are the agreed handover point between surveying, installation and electrical.

How do you create an interface list?

You create an interface list by asking, for every service in the project, what it requires and what builds on it. You write every interface found into a table with preceding trade, following trade, handover point, verification, date and responsible person. You agree this as a contract annex – not only on site. The list grows with the project and is updated at every site meeting.

Five steps to the list

The list is a contract annex

An interface list that is only created at the first site meeting comes too late. By then the contracts are signed, the prices calculated and the client-side provisions allocated – or not. Attach the list to the tender and have bidders comment on it. Bidders' questions about interfaces are not a nuisance but a pointer to where the list still has gaps.

What the installation contractor contributes

As a subcontractor we often see only our section of the project. But there we know the interfaces better than anyone else. What load-bearing capacity does the floor need for the lifting equipment, what door clearance must the transport route provide, how long does a cabinet stand at the lift, what lifting points must a delivery have? Ask the installation contractor about its interfaces before the award. It will give you a list the designer does not know in this form.

What does a responsibility matrix look like?

Overview: interfaces in large installation projects – responsibility matrix with ten tasks from target positions to maintainability and the assignment of who is responsible, who contributes and who is informed: client, designer, GC project management, manufacturer or specialist contractor, installation contractor, future maintenance team.
The responsibility matrix as a reading aid: exactly one responsible party per task, plus contributors and informed parties – the gaps and duplications are the points where the project later stalls. Graphic: Omega Mounting

A responsibility matrix is a table that records, for each task in the project, which party is responsible for it, who contributes and who is informed. In international project management this tool is called a RACI matrix. This table uses a simplified form: R (responsible), C (contributing) and I (informed); German site practice uses V, M and I for the same roles. Its value lies in the gaps: rows without an R and rows with two Rs are the points where the project later stalls.

TaskClient / operatorDesignerGC project managementManufacturer / specialist contractorInstallation contractorFuture maintenance team
Define target positions, axis grid, load assumptionsIRCCII
Verify load-bearing capacity of floor, ceiling, crane standing areaCRCII–
Provide installation route, openings, lift (by others)CCRIC–
Delivery with weights, lifting points, parts listIICRCI
Lift plan, lifting equipment, appointed person for lifting operationsIICIR–
Placement, surveying, alignment, fixingIICCRI
Electrical and utility connectionICCRCI
Test and approve safety devicesCICRCI
Commissioning, trial run, functional testCICRCC
Coordination of several employers, health and safety planRICCC–
Documentation package and handoverCCRCCR (takeover)
Check accessibility, spare parts, maintainabilityCCICCR

Reading the matrix

Two rows deserve particular attention. First, “coordination of several employers”: the R sits with the client, because the BaustellV (Construction Site Ordinance) obliges the client to appoint a coordinator when several employers work on one site. Even if the client delegates the task to a health and safety coordinator. Second, “accessibility, spare parts, maintainability”: the R sits with the future maintenance team. In many projects they are not at the table at all. That is exactly the gap that takes its revenge in every later maintenance window.

Bringing matrix and contract together

The responsibility matrix does not replace a contract, but it tests it. Every V must be found in a scope of works, a contract for work or an appointment. If the matrix contains a V that appears in no contract, the task is unpaid. And is therefore not done.

Suppression cylinder room at a data center – rows of nitrogen cylinders of the gas suppression system
The specialist contractor designs and commissions, the installation contractor installs: 240 cylinders, six banks, one clearly divided responsibility.

How do manufacturer, specialist contractor and installation contractor work together?

Manufacturers and specialist contractors design, supply and commission. The installation contractor moves in, places, installs and hands over. This division of labour works if the handover point between “mechanically complete” and “commissioned” is documented. And if the installation contractor as subcontractor provides the same evidence the manufacturer owes its client. For manufacturers, the installation partner is the extended workbench on site. For the client, the result should be a plant made from a single mould.

What the manufacturer needs

A manufacturer commissioning an installation partner needs three things. Schedule reliability, because its commissioning builds on the installation. Precision, because its warranty depends on installation quality. And evidence, because it has to pass it on to its client. Which evidence a subcontractor should provide, from public liability insurance through qualifications to the employers' liability insurance clearance certificate, is described in our guide to subcontractor evidence for installation work.

What the installation contractor needs

Conversely, the installation contractor needs from the manufacturer weights and centres of gravity, lifting points, installation instructions with torques and a parts list. Plus a contact person who answers questions about the plant before they arise on site. If the weight is missing, no lift plan can be produced. If the lifting point data is missing, installation day becomes improvisation.

Responsibility for lifting operations

Wherever lifting takes place, an appointed person for lifting operations is needed who is responsible for the lift plan, lifting accessories and authorisation of each lift. Under BS 7121 the AP plans the lift; a lift supervisor appointed by the AP supervises it on site. In large projects it must be clarified in writing whether this person is provided by the installation contractor, the crane contractor or the general contractor. Who takes on this role and what it covers is described in our guide to the appointed person for lifting operations.

Several employers, one site

As soon as manufacturer, installation contractor and electrical company are on site at the same time, Section 8 of the ArbSchG (German Occupational Safety Act) applies. The employers must cooperate in implementing safety measures and inform each other about hazards. DGUV Regulation 1 requires coordination for this and, where necessary, a supervising person with authority to give instructions. The interface list is not just a scheduling tool. It is the place where you record who informs whom about what – for instance that hot work is going on next to the installation area or that the lift is closed for heavy loads. UK readers: the closest equivalent is regulation 11 of the Management of Health and Safety at Work Regulations 1999 (co-operation and co-ordination).

Which handover points do you need – and how do you document them?

You need handover points at every interface at which a following trade builds on the result of a preceding trade. Every handover point is documented with a completion notice, a report or a test. That way both sides know that the handover has taken place – and what was handed over. The difference between “finished” and “completion notified” is the difference between opinion and verification.

Four handover points in installation work

Technical drawing of four handover points with document and photo each: area clear from client to installation, placement done from installation to electrical, mechanically complete to commissioning, handover from project to operation
Finished is an opinion, a release notice is proof – every handover point from area clear to handover to operation gets a document and a photo. Graphic: Omega Mounting

Photo documentation as proof of the interface

One photo per handover point, with date, position and condition, is the cheapest insurance against later disputes. Was the cabinet in line before the electrical trade arrived? Was the floor free of scratches before the following trade took over the area? Was the bolted connection tightened before the specialist contractor commissioned the system? Whoever photographed it does not have to prove it.

Staged commissioning

In large projects, everything is rarely commissioned at once. The specialist contractor commissions section by section, the electrical trade connects hall by hall. This requires handover points per section. And a list that shows which section is at which stage. How the staged tests in data centers proceed and what the installation contractor has to deliver for them is described in our guide to commissioning in the data center.

Cylinder valve with pressure gauge – every fitting must be leak-tight at 300 bar
Tightness of every bolted connection is the testable handover point before staged commissioning by the client.

Why should the future maintenance team be at the table from the start?

Explanatory graphic: interfaces in large installation projects – what the future maintenance team contributes before installation: accessibility, replaceability, lifting points, and spare parts and documentation, each with questions and the consequence if nobody asks them.
Four points the future maintenance team contributes before installation – and which can hardly be changed after commissioning. Graphic: Omega Mounting

The future maintenance team belongs at the table from the start because accessibility, maintenance areas, lifting points, replaceability and spare parts stocking are determined during design and installation. After commissioning they can hardly be changed. The maintenance team is the party that lives with the plant longest. And in most projects only finds out at handover what it has been given.

What the maintenance team contributes before installation

The interface project → operations

The last interface of every large project is the one between project and operations. The project team disbands, the maintenance team remains. They need the handover report, as-built documents, spare parts lists with lead times, test certificates and a briefing at the plant in order to maintain from day one instead of searching. This interface belongs in the responsibility matrix with the same weight as the crane standing area. Its handover point belongs in the construction programme.

How we do it in the Rhine-Main region

In the Rhine-Main region we almost always work on large projects as installation partner – on behalf of manufacturers, specialist contractors and general contractors. They want their plant placed and installed in data centers in Frankfurt and Offenbach, in logistics centres near Hanau and Darmstadt or in production halls in the surrounding area. From Rodgau the distances are short. What can be long are the interfaces.

If you contact us about interfaces on a large project, we first ask questions back: what is by others, what does the manufacturer supply, what do we do – and how do we recognise that we can start? We write the answers into an interface list that we submit with the quotation. What we contribute in installation services is described on our page on industrial installation in existing buildings. What makes data centers special in terms of interfaces is described on our page on data center construction in the Rhine-Main region.

Our own workshop in Rodgau is often the solution for an interface nobody planned. A transport frame for a delivery without lifting points, a lifting gantry for a hall without a crane runway, a bracket missing between plan and reality. When the manufacturer delivers from another federal state and the general contractor coordinates from a third, the installation contractor from the region is the one who is there on installation day. And who knows where to get steel in Frankfurt at six in the morning.

Completed steel mezzanine in the production hall at Kassel Airport
Plan and reality differ – the laser survey before installation is the interface between steelwork delivery and hall.

Project examples

Three projects from our project diary show what “interfaces large project installation” means in concrete terms. Between installation and electrical, between installation contractor and specialist contractor, between delivery and hall.

160 distribution cabinets, one interface to the electrical trade: data center in the Rhine-Main region

During the move-in and placing 160 power distribution cabinets in a data center in the Rhine-Main region the separation of trades was clear from the start. We took on the entire mechanical process: transport into the building, distribution across four levels from the basement to the second floor via the heavy-duty lift, unpacking, lifting off the pallets, laser surveying and positioning to the millimetre. The electrical connection work followed by the electrical trade.

The interface was a handover point in the literal sense. Every cabinet stood exactly at its laser-surveyed position, in line with its row and under its cable outlet, before it was approved for the next trade. Eight data halls with 20 cabinets each in two rows of 10, six lift-and-shift fitters, several weeks. And with 160 cabinets, zero rework for the electrical trade. The bottleneck was the heavy-duty lift. With four floors, 160 cabinets and a duration of several weeks, the material flow had to be scheduled just as precisely as the installation – an interface that deserves its own row in the list.

Specialist contractor designs and commissions, we install: suppression cylinder room in the Frankfurt area

With the installation of a nitrogen gas suppression system in a data center in the Frankfurt area we worked on behalf of a fire protection specialist contractor – a classic partner project. The specialist contractor designs, brings suppression technology expertise and approvals, and commissions. We deliver the installation. In two weeks, three fitters installed the cylinder racks, the pipework up to the existing building network and 240 nitrogen cylinders in six banks of 40 cylinders. Each was moved in, secured and connected individually.

The technical interface was the handover point “mechanically complete and tight”. At around 300 bar operating pressure, every leaking bolted connection would gradually lose pressure. That is why every connection was tightened under control and tested for tightness. Only then could the client commission the system section by section – without rework. The spatial interface was the connection to the existing building network. That is where our pipework ended and where the operator's responsibility for its network began.

Plan and reality: steel platform at Kassel Airport

With the installation of a steel platform for a manufacturing company at Kassel Airport the platform was delivered ready-made. The interface between delivery and hall showed itself immediately: between plan and reality there is almost always a deviation. That is why the hall was laser-surveyed before installation and all important points were marked. Only when the first bay stood, was precisely aligned and the diagonal dimensions were correct did installation continue.

Two further interfaces are typical. The lifting gear – here an existing overhead crane for the heavy floor plates. Where there is none, the customer provides a forklift or telehandler. And the safety devices, which were installed together with the first plates so that nobody falls. Railings and stairs are not a following trade but part of the installation sequence.

Do you have a large project coming up in which manufacturers, specialist contractors and installation have to come together? Then get in touch with us. An interface meeting before the award usually clarifies within two hours what is by others, what the manufacturer supplies and where the installation contractor hands over.

What this means for your role

For buyers: Attach the interface list to the tender and demand a statement on it from every bidder. Silence means the interfaces have not been read. Write client-side provisions into the scope of works with date and responsible person, not just with the words “by others”. Regulate how notices of obstruction and variations at interfaces are handled. A responsibility matrix with contract references shows you whether every V is also paid for.

For designers: Draw the interfaces into your plans: handover flanges, terminal boxes, target positions with axis grid, load assumptions for lifting equipment, installation routes that remain after construction. Ask the installation contractor about its interfaces before design approval – door clearances, load-bearing capacities, lift dimensions, lifting points. Bring the future maintenance team to the table for accessibility and replaceability.

For project managers and site managers: As project manager, you keep the interface list and responsibility matrix as living documents. Updated at every site meeting, with dates from the construction programme and bottlenecks as separate rows. As site manager, you are the one who gives completion notices for handover points: area clear, lift clear, placement complete, mechanically complete. Give completion notices in writing, with date and photo, and demand the same from every trade. The completion notice is the moment at which the interface becomes real.

For maintenance managers: Get yourself invited to the table before the plant is in place. If nobody invites you, invite yourself. Check accessibility, maintenance areas, lifting points, replaceability of the largest component and the spare parts list with lead times before the installation opening is closed. At handover, demand a complete documentation package, a worked-off snagging list and a briefing at the plant.

For manufacturers and system suppliers looking for an installation partner: Give your installation partner what it needs for the lift plan – weights, centres of gravity, lifting points, installation instructions with torques, parts list. Agree the handover point “mechanically complete” with a report before your commissioning begins. Demand the subcontractor evidence you owe your client. Clarify in writing who provides the appointed person for lifting operations. An installation partner from the region is there on installation day when you cannot be.

For occupational safety specialists and HSE coordinators: Check whether the interface list also contains the occupational safety interfaces: who informs whom about hot work, lifts, closed routes and lifts? Who is the supervising person when several employers work at the same time? Has the coordinator under the BaustellV been appointed and is their health and safety plan coordinated with the installation sequence? The German technical rule TRBS 1111 requires that a coordinator is appointed in writing and given authority to issue instructions. Demand this appointment before the first trade arrives.

Interface list on request

The templates for scope of works and interface list that you need for the tender are described in our guide to the scope of works for plant installation. The interface list with the eight interfaces from this article helps buyers with the tender and project managers in the site meeting. Request it via our contact form – subject line “installation interface list”.

Why Omega Mounting?

From Rodgau near Frankfurt, Omega Mounting works as installation partner in large projects. On behalf of manufacturers, specialist contractors and general contractors, in data centers, logistics centres and production halls in the Rhine-Main region and beyond. The linked projects show what interface work means for us. 160 distribution cabinets handed over to the electrical trade without rework. 240 suppression gas cylinders handed over tight for commissioning by the specialist contractor. A steel platform set into a hall after laser surveying that was different from the plan. With our workshop in Rodgau we close gaps between plan and reality. With our own lifting equipment and an appointed person for lifting operations we take responsibility for every lift. We can be reached by phone or WhatsApp when an interface gets stuck at the weekend. With us you get a single point of contact, who reads your interface list, adds to it and keeps to it on installation day – with short distances in the Rhine-Main region.

Conclusion

Interfaces in large projects decide the schedule, quality and variations of the installation – not the plant itself. Clarify every interface spatially, temporally and technically, and write it into an interface list with preceding trade, following trade, handover point and verification. Distribute responsibilities in a matrix without gaps or duplication and involve the future maintenance team from the start, and you get a plant from a single mould – even if five companies built it. That is all there is to interface management on large projects – and less is not enough. Send us your project description, the construction programme and the list of trades involved. We will get back to you with an honest assessment of which interfaces in your project need attention.

Planning a move-in, installation or maintenance in the Rhine-Main region?

Tell us briefly what you need – we'll come back with an honest assessment.

Free, no-obligation callback

Tobias Schott, managing director of Omega Mounting GmbH, on a construction site in front of scaffolding

About the author

Tobias Schott

Managing director of Omega Mounting GmbH, Rodgau · more than 20 years of hands-on experience in installation and maintenance

A trained mechatronics technician, working in maintenance, servicing and industrial installation since 2004 – first alongside his father, and with Omega Mounting since 2012: from overhead conveyors in Frankfurt to the crane system in a new-build hall. He plans and leads lifting operations as an appointed person (AP) in data centers and on industrial sites in the Rhine-Main region, trains and examines operators of cranes, mobile elevating work platforms and telehandlers, and is a qualified occupational safety specialist. On jobs abroad he is known as the “German Troubleshooter” – the person you call when a site gets stuck. He learned what quality means from his father, not from a manual: Made in Germany as a standard for his own work, not a label. That is why quality comes first at Omega Mounting – ahead of speed and price. He writes these guides from that practice: what works on our sites is in them – what exists only on paper is not.

Frequently asked questions

The scope of works describes what a contractor performs. The interface list describes what lies between the services – who hands over what to whom and when, and how this can be recognised. The two belong together: every client-side provision in the scope of works needs a row in the interface list with date, responsible person and completion notice. Without the list, interfaces are negotiated on installation day.

Normally the client or its GC. The BaustellV (Construction Site Ordinance) obliges the client to appoint a coordinator when several employers work on one site. Under VOB/B (German construction contract procedures), the client has to coordinate the services of the various contractors. The employers themselves must cooperate under Section 8 of the ArbSchG and inform each other about hazards. The responsibility matrix makes visible who performs these tasks.

“By others” means that the client provides a prerequisite – power, crane, lift, scaffolding, isolation, access. The problem is the missing date. Without a date and responsible person it is not clear when the provision must be in place, and on installation day it is missing. Write every client-side provision into the interface list with date, responsible person and completion notice.

With a written completion notice or a report containing date, condition and signatures from both sides, supplemented by photos of the area or plant handed over. For “mechanically complete”, the installation report, torque record and – for pressurised systems – a tightness test report are included. What is photographed and signed does not have to be proven later. This does not replace a legal review of your contract documents.

Before design approval and at the latest before the installation is awarded – i.e. before installation routes, maintenance areas, lifting points and spare parts lists are fixed. After commissioning, accessibility and replaceability can hardly be changed. Handover to operations is the last interface of the project and belongs in the responsibility matrix with the same weight as the crane standing area.

The same evidence the manufacturer owes its client: public liability insurance, proof of qualification for crane operators, slingers and MEWP operators, clearance certificate from the statutory accident insurance institution, tax exemption certificate. Plus the risk assessment for its own activities and, wherever lifting takes place, an appointed person for lifting operations appointed in writing, with a lift plan. A prequalification bundles this evidence once.

Keep the lift as a separate row in the interface list with an occupancy schedule and responsible person. Schedule the material flow with the installation and define who decides in the event of conflicts. When placing 160 distribution cabinets on four levels in a data center in the Rhine-Main region, the heavy-duty lift was the bottleneck that determined the entire takt.

Yes. We work to the GC’s responsibility matrix and interface register and fill in our own rows: preceding trade, handover point, verification and date. On a data center project our scope typically ends when the unit is rigged into place and anchored – the point at which the commissioning agent can issue the red tag (Level 2A).

From Rodgau, Omega Mounting works as installation partner for manufacturers, specialist contractors and general contractors in Frankfurt, Offenbach, Hanau, Darmstadt and throughout the Rhine-Main region. We submit an interface list with the quotation, provide the appointed person for lifting operations and hand over to the following trade with an installation report and photo documentation.

Yes – that is our usual role on large projects. We work as installation subcontractor to a manufacturer, a specialist contractor or the general contractor, follow the GC’s site rules, induction and permit system, and hand the installed unit over at a documented point before the manufacturer’s commissioning.
