Custom metalwork fabrication and installation: workshop or catalogue?

By Tobias Schott  · 23-minute read · Updated October 2026

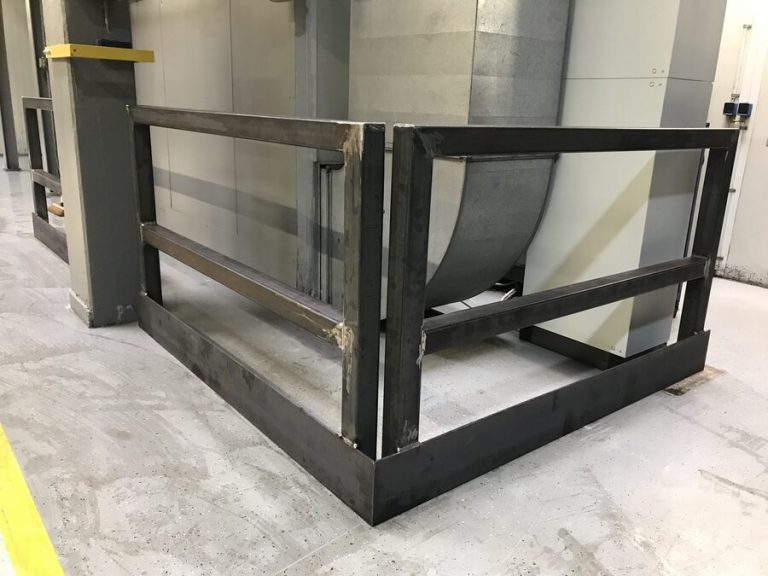

Bare, as-welded guard of 80x80 steel tube on an anchored steel angle
Made-to-measure impact protection, bare and as-welded in our workshop in Rodgau – before primer and signal colour.

A custom fabrication in metalwork is the better answer when geometry, load, connection to the existing plant or delivery time deviate from what a standard component was built for. In all other cases the tested catalogue part is faster and cheaper.

The bracket does not fit because the new plant has different hole patterns from the old one. The impact protection from the catalogue cannot withstand the forklift traffic. No manufacturer stocks the spare part for the plant from the nineties any more. The oil pan would have to fit exactly around a concrete foundation that exists only once. If you work in maintenance, planning or purchasing, you know these moments. The search for custom metalwork fabrication with installation then begins with the question of whether workshop and installation from one contractor are the better answer than the matching standard part.

The question is not trivial. Standard components have advantages that a workshop cannot beat: tested load assumptions, documentation, availability from stock, interchangeability. Custom fabrications have advantages that no catalogue offers. They fit the plant, not the plant to them; they carry the load that actually occurs; and they are often there sooner than a part with a delivery time.

This guide provides the decision logic: which five questions decide, what the route from site survey through fabrication to installation in the plant looks like, which materials and surfaces are available. Plus where the limits lie and how to enquire about and tender a one-off from the workshop so that no variation arises. It builds on our introductory article on the scope of works for plant installation, because the custom fabrication is the item most often missing there.

Key points at a glance

What is a custom fabrication in metalwork with installation?

A custom fabrication in metalwork is a component or structure made of steel, stainless steel or aluminium, manufactured as a one-off to site survey, sketch or drawing for a specific installation situation. The standard component, by contrast, is mass-produced for a typical application. Typical custom fabrications from steel construction and the metalwork shop for industry are brackets, mountings, adapter plates, intermediate frames, impact protection and collision guards, drip trays, fixtures and auxiliary structures for installation. Plus guardrails and small platforms as well as spare parts such as pins, bushes, shafts and levers.

Compared with a Repair a custom fabrication differs in that something new is created – whereas a repair makes an existing part functional again, for example by repair welding. In practice, the two merge: a cracked bracket is not welded but replaced by a reinforced new fabrication; a worn shaft is repaired with a re-manufactured pipe segment.

Compared with a standard component a custom fabrication differs by its batch size of one and by its fit to the plant: the catalogue part brings its own dimensions, the custom fabrication takes over the dimensions of the plant. That is why every custom fabrication starts with the site survey and not with the data sheet.

Compared with a structural steelwork in the building sense it differs in its subject matter. It is plant equipment, machine attachment or fixture, not a load-bearing component of a building – to which DIN EN 1090 applies, more on this below.

Standard component or custom fabrication: which five questions decide?

Explanatory graphic: custom metalwork fabrication and installation – five decision questions on geometry, loading, connection to the existing plant, delivery time and availability of a standard component
Five questions decide whether catalogue goods are enough or the workshop is the better answer: if every answer is yes, buy; if one answer is no, have it fabricated. Graphic: Omega Mounting

Five questions decide whether a standard component is enough or the workshop is the better answer. Does the geometry fit? Is the loading known and covered by the standard? Can the part be connected to the existing plant? Can it be delivered in time – and is there still a standard part at all? If all five answers are yes, buy. If one answer is no, have it fabricated.

Question 1: Does the geometry fit?

Standard components have fixed dimensions and hole patterns. If the part fits without rework – without filing out slots, improvising shims or moving the plant – it is the right choice. As soon as several adaptations become necessary, the custom fabrication to site survey is usually cleaner and faster.

Question 2: Is the loading covered?

A catalogue impact guard is designed for a typical impact. If a forklift with a mesh box passes the same corner every minute at high speed, the actual loading lies outside what the standard part was built for. Then only a structure dimensioned for speed, cycle rate and load will help – with wall thickness, section and anchoring that suit the situation.

Question 3: Can the part be connected to the existing plant?

Existing plant has hole patterns, flanges, rails and foundations that cannot be changed. An adapter plate between new unit and old foundation, an intermediate frame between replacement motor and existing bracket, a pan that runs exactly around a foundation. These do not exist in the catalogue because the situation exists only once.

Question 4: Can the part be delivered in time?

If the standard part has weeks of delivery time and the plant is down, a custom fabrication from the workshop in days or hours is the more economical solution. Not because it is cheaper, but because it shortens the downtime. For plannable measures, the argument reverses: then delivery time is not a problem, and the catalogue part wins.

Question 5: Is there still a standard part?

For plant whose manufacturer no longer exists or no longer carries the series, there is no standard part any more. Obsolescence – the unavailability of spare parts – turns maintenance into fabrication: remaking from a sample or drawing is then the only way to keep the plant running.

Criterionstandard componentCustom fabrication
GeometryFixed dimensions, hole patterns, heightsTo site survey of the plant
Load assumptionsTested and documented for the typical caseDimensioned for the actual loading
Connection to existing plantOnly with matching interfacesAdapters, intermediate frames, fitted pieces included
AvailabilityFrom stock or with delivery timeFabrication time in the workshop, often days
DocumentationData sheet, manufacturer's test certificateSketch/drawing, material certificate, installation report
InterchangeabilityCan be reordered at any timeCan be remade to drawing
Typical caseNew plant, standard situation, plannable procurementExisting plant, breakdown, obsolescence, special load
Steel fabricator pre-drilling the loading dock with the magnetic drill for the impact protection
Adaptation on site to the existing plant – pre-drilling with the magnetic drill at the loading dock.

How does a custom fabrication in metalwork proceed from site survey to installation?

A custom fabrication in metalwork proceeds in six steps: site survey, sketch or drawing, definition of material and surface, fabrication in the workshop or adaptation on site, installation in the plant and documentation. Keep these steps with one contractor and you avoid the interface at which most custom fabrications fail. It lies between the one who measures, the one who fabricates and the one who installs.

Step 1: the site survey

Technical drawing of a site survey for a custom part: defined reference edge, obstructions such as pipe and cable tray, existing holes in the wall, floor unevenness measured, every dimension with tolerance
A custom part is measured from a named reference edge – including obstructions, existing holes, floor unevenness and a tolerance for every dimension. Graphic: Omega Mounting

The site survey is the measurement of the installation situation on site – with tape measure, laser, template or impression. It records not only the part but its surroundings: obstructing edges, floor unevenness, existing holes, service lines, travel routes, tolerances of the existing plant. A survey by the customer is possible but the most common source of error: missing reference edge, forgotten obstructing edge, dimension without tolerance. Our experience: whoever fabricates should also measure.

Step 2: sketch or drawing

Not every custom fabrication needs a CAD drawing. A dimensioned hand sketch is enough for brackets, mountings and simple frames. A drawing with tolerances is needed when fits matter – for pins, bushes, adapter plates with hole patterns. Likewise when the part is to be remade later or the customer wants an approval before fabrication.

Step 3: material and surface

Material and surface follow from loading and environment – see the next section.

Step 4: fabrication – in the workshop or on site

Technical drawing comparing the workshop – welding with extraction, milling, drilling and cutting – with on-site work at the plant – magnetic drill on existing steel, corners welded in under a hot work permit
Whatever can be done under controlled conditions is made in the workshop; on site only drilling into existing steel and welding in corners under a hot work permit. Graphic: Omega Mounting

What can be fabricated in the workshop is fabricated there: cutting, welding, drilling, milling, turning, coating. There, conditions are controlled, with extraction and without the operator's fire protection requirements. What has to be adapted to the existing plant is adapted on site: drilling with the magnetic drill on the existing steel, tapping threads, welding in corners.

Step 5: installation in the plant

Installation and retrofitting during ongoing operations follow the rules of every job in an existing facility. Approval by the operator, cordoning of the work area, for welding or cutting work a permit to work for hot work with fire watch. Plus anchoring with heavy-duty or chemical anchors to manufacturer's specification, visual inspection and completion notice. In a data center, the ban on grinding and welding in the data hall is added. There, prefabrication takes place in the workshop and only bolting is done on the technical areas (grey space). What to watch out for in repair welding in an operating plant is described in our guide on repair welding on industrial plant – the same applies to custom fabrications.

Low-dust adaptation and anchoring

Abrasive cutting, grinding and drilling anchor holes are the most dust-intensive steps of an on-site installation. Angle grinders and drills are among the hand-held machines with high dust emission. Drilling into concrete or masonry produces mixed dust with respirable crystalline silica, which is classified as carcinogenic – according to the BG BAU/BAuA module “Site set-up – low-dust working”. The measures follow the STOP principle. The most effective substitution is prefabrication in the workshop, where welding and grinding are done with extraction. What remains on site runs with technical safeguards: rotary hammer with extraction at the drill bit, dust class M extractor, wet methods for cutting concrete, air cleaners with exhaust filtration and fresh air supply in enclosed rooms. Dry sweeping or blowing off dust deposits with compressed air is not permitted under the Hazardous Substances Ordinance (GefStoffV). Cleaning is done by vacuuming or wet methods.

Step 6: documentation

Sketch or drawing, material specification, coating system, anchoring, photo documentation, installation report. For spare parts, additionally the dimensions in a form in which the part can be remade next time without a site survey.

Which materials and surfaces come into consideration?

Material and surface of a custom fabrication follow from loading, environment and visibility. Structural steel with coating for most industrial applications, stainless steel for food, wet areas and chemicals, aluminium where weight counts. Plus a surface that ensures corrosion protection and visibility for as long as the part is in use.

Materials

Surfaces

Technical drawing in four cross-sections of a welded joint: raw weld with spatter and scale, weld ground flush with broken edges, primer and safety-colour top coat, and coating cracking over a raw weld
A durable coating needs a weld ground flush, edges broken and scale removed – on a raw weld the coating cracks at edge and seam. Graphic: Omega Mounting

The surface also includes preparation: welds are ground flush, edges broken, scale removed. A coating on an unground weld does not hold – and on a drip tray, the ground, primed and painted weld is also the sealing plane.

Primed guard – corrosion protection before the signal yellow topcoat
Primer first, then signal colour – the surface decides on corrosion protection and visibility.
Freshly welded corner of the drip tray on the concrete foundation of the test rig
A continuous oil pan, welded leak-tight on site at the concrete foundation – a bought-in part would not have fitted here.

When does maintenance become fabrication?

Maintenance becomes fabrication when a part has to be replaced that can no longer be bought. Or that never existed because the plant was modified over its lifetime. For maintenance managers, this is the most common reason to need a workshop: not for the big conversion, but for the pin, bush or bracket without which the plant stands still.

Remake from a sample

If the old part is available, it is measured and remade – with an eye on the cause of the wear. A pin that has worn is made to the same dimension, but if necessary from a more wear-resistant material or with a different bush pairing. Reverse engineering, recovering the manufacturing dimensions from the component, replaces the missing drawing. What this looks like for conveyor technology is shown in our guide on wear on overhead conveyors using the example of pins and bushes.

Remake with improvement

Maintenance according to DIN 31051 recognises, besides servicing, inspection and repair, improvement – increasing reliability without changing the function. The custom fabrication is the tool for this. The bracket that has cracked twice gets a stiffening rib the third time. The impact guard that was bent gets a floor rail that directs the forces into the floor instead of the plant.

Avoiding substantial modification

One limit must be observed. Modifying a component so that the function, safety or performance of the machine changes may trigger a substantial modification within the meaning of product safety law – with new obligations for the operator. A dimensionally identical remake or a reinforcement without change of function is usually not that. A conversion that affects safeguards or extends the use may be. If in doubt, we clarify this with you before fabrication and document the decision.

Where are the limits of custom fabrication?

Explanatory graphic: custom metalwork fabrication and installation – the three limits: load-bearing building components under DIN EN 1090, components with type examination under TRBS 1201, and the better standard part
Load-bearing building components, tested safety components and the case in which the catalogue part is simply better – three limits that an honest workshop names before the quotation. Graphic: Omega Mounting

Custom fabrication has three limits: load-bearing components of a building, components with statutory type examination, and cases in which the standard part is simply better.

Load-bearing building components: Columns, beams, crane runways, platforms that become part of the building fall under DIN EN 1090 “Execution of steel structures and aluminium structures”. They must be supplied by a manufacturer certified for this with the appropriate execution class. Plant equipment, fixtures, brackets on machines and protective structures are usually not affected. Where the line lies in the individual case, we clarify before the quotation – and tell you openly if a fabrication belongs with a steel construction company certified for this.

Components with type examination: Load-handling attachments, lifting accessories, anchor devices for persons, pressure equipment and safety components are subject to their own standards and inspection duties. A spreader beam as a custom fabrication is possible, but needs calculation, marking and inspection in accordance with the German technical rule TRBS 1201 (inspections of work equipment). It requires inspection before first use by a competent person and periodically thereafter, annually for load-handling attachments. A fabricated part that lifts or carries loads goes into service only with an inspection record. An improvised anchor point for persons is not permitted.

The better standard part: A workshop that replicates a catalogue part that fits and is available wastes your money. The right answer to an enquiry is therefore sometimes: “Buy the part, we will install it.”

How do you enquire about and tender a custom fabrication?

Overview: custom metalwork fabrication and installation – seven details for enquiry and scope of works from installation situation via loading and interfaces to installation conditions and documentation
Seven details with which every bidder prices the same service – and the custom fabrication does not become a variation. Graphic: Omega Mounting

A custom fabrication is enquired about and tendered so that the bidder knows the installation situation, the loading, the interfaces and the installation conditions – then everyone prices the same service and no variation arises. In the scope of works, it belongs as a separate item – for example “custom fabrication metalwork/installation” – described with site survey, design, fabrication, surface, delivery and installation, not as a contingent item “small parts on a time basis”.

What belongs in the enquiry:

When awarding, it is worth asking about the workshop: does the bidder fabricate in-house or buy in? With in-house fabrication, we can rework parts in a breakdown and change dimensions if something shows up during installation. No second company is needed for the installation. Why proximity to the workshop counts in a breakdown is explained in our guide on the installation contractor in the Rhine-Main region.

How does the custom fabrication get safely to the site?

Explanatory graphic: custom metalwork fabrication and installation – checklist for delivery, interim storage, contract and pre-assembly area as well as collision protection, so that the fabricated component gets safely to the site
Delivery, interim storage and protection of the component are planned before installation – ideally so that no storage takes place at all: the frame is finished in the workshop and arrives with the installation team. Graphic: Omega Mounting

A custom fabrication gets safely to the site when delivery, interim storage and protection of the component before installation are planned – ideally without interim storage. The BG BAU/BAuA module “Site set-up – traffic areas, transport routes, storage areas and parking areas” recommends avoiding interim storage, especially in confined spaces, and arranging storage areas within the crane's slewing range and in the delivery area. A nearby workshop makes this possible: the frame is finished in Rodgau and arrives with the installation team at the installation point.

If storage is nevertheless required, the module's rules apply. Secure frames and sheets stored upright against tipping, all parts against falling over and rolling away. Keep routes of at least 0.50 metres (module requirement) clear between storage areas and have the load capacity checked for interim storage on upper floor slabs. Storage rules belong in the contract – in the scope of works as a line “storage and pre-assembly area by others”. Pre-assembly needs its own area next to the storage, not the traffic route.

Collision protection applies in both directions. Workplace and parked component in the travel area of forklifts and trucks are protected with barriers, guide posts or guide walls. Conversely, existing plant and service lines within the crane's slewing range are marked and bypassed at a distance.

Finished impact protection at the loading dock of Frankfurt Airport
Ten millimetres of steel against incoming dollies – the finished impact protection at the loading dock.

Project examples

In our practice, custom fabrications come in three forms. Planned from the workshop, adapted on site to the existing plant, and improvised from the material when something is missing. Four jobs from our project diary show all three.

Impact protection from the workshop: Offenbach

For a production company near Offenbach, where forklifts with mesh boxes pass sensitive plant technology every minute, we built a custom-made impact protection – a 200 × 100 × 10 millimetre steel angle as an anchored floor rail, on top of it a frame of 80 × 80 × 5 millimetre steel tube, anchored in the floor with heavy-duty anchors, primed and painted in signal yellow. Two people welded the structure in our workshop in Rodgau in about a day, two metalworkers installed it in a single working day. The decision against the catalogue part was made at question 2: the loading from speed, cycle rate and load lay outside what standard impact protection is built for. The decision logic behind this is described in our guide Impact protection: buy standard or have it custom made?

Adaptation on site: loading dock at Frankfurt Airport

At a logistics facility at Frankfurt Airport, we built impact protection made of square tube with ten millimetre wall thickness against incoming dollies. Three metalworkers, four days, adaptation and installation entirely on site at the existing plant. The square tubes were pre-drilled with the magnetic drill, the loading dock drilled and tapped. Then the tubes were installed, the corners welded in and painted in a matching colour. Here question 3 was decisive: the connection dimensions to the dock's existing steel could not be taken to the workshop – so the workshop came to the plant.

Oil pan around a foundation: test facility of a car manufacturer

In the test facility of a car manufacturer in southern Germany, we converted the hydraulic lines of a test rig and installed a continuous oil pan at the concrete foundation. Two fitters, three days. The pan segments were set around the foundation, fixed with anchors and bolts, every corner and every transition welded leak-tight using the TIG process. The gap to the concrete wall was sealed with oil-resistant sealant, the welds ground flush, primed and painted. Welding was done in the basement with welding fume extraction and fresh air supply. A bought-in part would not have fitted here – the foundation exists exactly once.

Improvised from the material: cable reel in Aschaffenburg port

In Aschaffenburg port, a cable reel weighing around 22 tonnes was to be enclosed in two layers of UV-protection tarpaulin and loaded. The tarpaulin came with eyelets but without the announced fastening system – and the low-loader was already waiting. Three fitters enclosed and loaded the cable reel while suspended: while two prepared the reel for the lift on site, the third procured clamps, wire ropes, lashing straps and cable ties from suppliers. From these, attachment points on the reel flange were created that had not existed before – removable without damage, because the reel goes back into circulation. After a few hours, the low-loader was loaded. From Rodgau to Aschaffenburg: around 35 kilometres.

Are you missing a part that cannot be bought – or does the catalogue part not fit your plant? Then get in touch with us. With photos of the installation situation, we can usually tell you the same day whether workshop or catalogue is the better answer.

What this means for your role

For buyers: Include the custom fabrication as a separate item in the scope of works – with site survey, design, material, surface, delivery, installation and documentation. Do not hide it under “sundries on a time basis”. When awarding, ask whether the bidder has its own workshop, and rate proximity and response time as a suitability criterion. In a breakdown, fabrication time decides the downtime.

For designers: Plan interfaces so that later custom fabrications remain possible. Access to foundations and brackets via inspection openings, space for adapter plates, reserve in hole patterns, access routes and installation openings with sufficient clear width for prefabricated frames. Define which components fall under DIN EN 1090 so that plant equipment and load-bearing structure are not tendered in the same item. Specify material and surface requirements from the environment – hygiene, wet conditions, outdoor area – not from the catalogue.

For project managers and site managers: The project manager clarifies drawing approval, date and installation window before fabrication. The site manager ensures on site that survey and installation situation match, that hot work runs with permit to work and fire watch, and that anchors are set to manufacturer's specification. Both should agree one rule. What turns out to deviate during installation is documented and resolved with the workshop – not on site with a hammer. The site manager also assigns the delivery a storage and pre-assembly area outside the traffic routes.

For maintenance managers: For your critical plant, define which wear parts are no longer available and have drawings or samples made before the last old part fails. Use every repair for improvement according to DIN 31051: what has broken twice is made reinforced the third time. And record which workshop within reach can fabricate at the weekend.

For warehouse and logistics managers: Impact protection, collision guards, racking protection and transfer points are the most common custom fabrications in logistics, because forklift traffic, doors and docks are different everywhere. After every impact damage, check whether the standard part was up to the loading. If not, the custom fabrication with floor rail and suitable wall thickness is the more durable solution. During installation, also protect the workplace and the delivered component with barriers and safety distance.

For manufacturers and system suppliers looking for an installation partner: When installing your plant in an existing facility, something is almost always missing – a bracket, an adapter, a fitted piece. An installation partner with its own workshop solves this in the same job, instead of interrupting the site and asking you for a replacement part. Clarify in advance which adaptations the installation partner may fabricate itself and how they are documented, so that your declaration of conformity remains unaffected.

Site survey and enquiry form for custom fabrication: template on request

Our site survey and enquiry form for custom fabrication is a one-page template with which buyers, designers and maintenance staff describe a custom fabrication so that it can be quoted without follow-up questions. It contains the five decision questions, installation situation with reference edges and tolerances, loading, material and surface, interfaces, installation conditions, date – and a sketch area for the site survey. Request the form via our contact form – subject line “custom fabrication enquiry form”.

Why Omega Mounting?

In our own metalwork shop in Rodgau near Frankfurt – with welding equipment and milling machine – we fabricate one-offs for existing plant. Pins, bushes, shafts, levers and mountings, remakes from samples, fitted pieces and adapters, reinforcements and brackets, made-to-measure collision and impact protection, fixtures and aids. Site survey, design, fabrication and installation come from one contractor, as the jobs in Offenbach, at Frankfurt Airport, in Aschaffenburg port and in the test facility in southern Germany show. From Rodgau, we are quickly on site in Offenbach, Frankfurt, Hanau, Dietzenbach and Aschaffenburg, and by phone or WhatsApp also in a breakdown. More about our custom fabrications for existing plant can be found on the service page. Metalwork in the Rhine-Main region with one contact for site survey, fabrication and installation – and a workshop that replaces delivery time in a breakdown. Get in touch with us, before you adapt the next catalogue part.

Conclusion

Custom fabrication or standard component is not a matter of faith but a decision along five questions: geometry, loading, connection to the existing plant, delivery time and availability. If the catalogue part fits, buy it. If it does not fit, the workshop is the better answer – with site survey, drawing, suitable material, the right surface and installation by the same team. Custom metalwork fabrication with installation has two limits: load-bearing building components and tested safety components – an honest workshop names them before the quotation. Send us photos of the installation situation, the approximate dimensions and your date – we will get back to you with an honest assessment of whether we measure, fabricate and install, or whether you are better off buying.

Planning a move-in, installation or maintenance in the Rhine-Main region?

Tell us briefly what you need – we'll come back with an honest assessment.

Free, no-obligation callback

Tobias Schott, managing director of Omega Mounting GmbH, on a construction site in front of scaffolding

About the author

Tobias Schott

Managing director of Omega Mounting GmbH, Rodgau · more than 20 years of hands-on experience in installation and maintenance

A trained mechatronics technician, working in maintenance, servicing and industrial installation since 2004 – first alongside his father, and with Omega Mounting since 2012: from overhead conveyors in Frankfurt to the crane system in a new-build hall. He plans and leads lifting operations as an appointed person (AP) in data centers and on industrial sites in the Rhine-Main region, trains and examines operators of cranes, mobile elevating work platforms and telehandlers, and is a qualified occupational safety specialist. On jobs abroad he is known as the “German Troubleshooter” – the person you call when a site gets stuck. He learned what quality means from his father, not from a manual: Made in Germany as a standard for his own work, not a label. That is why quality comes first at Omega Mounting – ahead of speed and price. He writes these guides from that practice: what works on our sites is in them – what exists only on paper is not.

Frequently asked questions

A custom fabrication in metalwork with installation is a one-off made of steel, stainless steel or aluminium that is manufactured to site survey, sketch or drawing for a specific installation situation and then installed. Typical examples are brackets, adapter plates, impact protection, drip trays, fixtures or spare parts. The difference from the standard component is the fit to the plant: the catalogue part brings its own dimensions, the custom fabrication takes over the dimensions of the existing plant.

When geometry or hole pattern do not fit, when the actual loading lies outside what the standard part is designed for, or when the part has to be connected to existing plant. Likewise when the delivery time extends the downtime or there is no standard part any more. If the catalogue part fits, is tested and is available from stock, it is the better choice.

With sketch or drawing, material specification, coating system, details of anchoring, photo documentation and installation report. For spare parts, additionally with manufacturing dimensions so that the part can be remade next time without a site survey. These documents belong in the plant's as-built documentation.

Reverse engineering is the recovery of manufacturing dimensions from an existing component when no drawing exists any more. The old part is measured, wear is calculated out, and the part is remade – if necessary from a more wear-resistant material. For plant without spare parts supply, this is often the only way to keep it running.

No. DIN EN 1090 applies to load-bearing components of buildings – columns, beams, crane runways, platforms that become part of the building – and requires a certified manufacturer for them. Plant equipment, fixtures, brackets on machines and protective structures such as impact protection are usually not affected. Where the line lies in the individual case should be clarified before the quotation.

The same as for every job in an existing facility: operator approval, a cordoned-off work area, and for welding and cutting a hot work permit with fire watch and extraction. Add anchoring to the manufacturer's specification and a job-specific risk assessment under Section 5 ArbSchG. Dust is avoided by prefabricating in the workshop and extracting at the tool. If the part carries or lifts loads, it is inspected before first use under TRBS 1201.

Both, depending on the component. What can be fabricated under controlled conditions is made in our workshop in Rodgau. What has to take connection dimensions from the existing plant is adapted on site, for example by drilling with the magnetic drill on the existing steel. Often it is a combination: prefabricated in Rodgau, adapted and installed at the customer's.

That depends on component, material and surface – the proximity of the workshop shortens the chain. Site survey in Offenbach, Hanau or Aschaffenburg, fabrication in Rodgau, installation often in the same or next job. In a breakdown, the fabrication time in the workshop replaces the delivery time of a catalogue part – which is why the workshop is part of our breakdown readiness by phone or WhatsApp.

Via a short enquiry with three details: photos of the installation situation, the approximate dimensions or an as-built drawing, and the date – breakdown or plannable measure. We will first tell you whether a standard part is enough. If not, we come for the site survey, clarify material, surface and installation conditions on site and send you a written quotation with sketch. Your contact is Tobias Schott – reachable via our contact form; our site survey and enquiry form guides you through all the details.
