The Standby Power System: Everything That Makes Up Data Center Backup Power

By Tobias Schott  · 8-minute read · Updated October 2026

Tandem lift at night: two mobile cranes lifting a containerised standby power system over a data center in the Frankfurt area
A standby power system as a containerised unit arrives complete: engine, alternator, cooling and exhaust system in one enclosure.

A standby power system takes over the electricity supply of a data center when the public grid fails – and it consists of far more than the diesel engine and alternator that give it the name standby generator. You will meet the standby power system in every data center tender, usually under the German abbreviation NEA (Netzersatzanlage). In the generator room it stands as a block of engine and alternator; outside, it is a container behind the building. Add tanks in the pit, exhaust pipes on the roof and radiators on the façade – and all of it together is the system.

Once you know the parts, you understand the schedules, the floor space and the maintenance windows a data center sets aside for them. Here we explain what a standby power system is, what belongs to it, how the start sequence runs and what is mechanically maintained on it.

What is a standby power system?

A standby power system is a stationary power generation plant that takes over the supply of the connected loads when the public grid fails – at its core a diesel engine driving an alternator, together with controls, cooling, exhaust system and fuel supply. In English it is called an emergency generator set or genset, in tenders also a standby generator. In German, Notstromaggregat, Notstromgenerator and Netzersatzanlage are used side by side; the technical term for the complete system is Netzersatzanlage.

It should not be confused with the UPS, the uninterruptible power supply. The UPS is a battery system that keeps supplying the load without a gap until the standby power system has started and takes over. One bridges the gap, the other carries the load. We work on the standby power system as an installation and maintenance partner; by arrangement, our own qualified electricians handle work on the system electrics, the control belongs to the manufacturer, the feed-in and building electrics to the operator.

Key facts

Diesel engine of a standby power system on its transport frame before installation in the generator room
The heart of the system: with the indoor unit, the diesel engine arrives as a separate module and is only connected to the rest in the generator room.

What belongs to a standby power system?

A standby power system consists of seven main components that only deliver power together: engine, alternator, controls, cooling, exhaust system, fuel supply and ventilation. With the indoor unit, the components enter the building one by one and are only connected in the generator room. That covers the radiator with its pipework to the engine, the SCR system, manifold and exhaust run, lines, AdBlue tanks and switch cabinets.

PartTaskTypical fault source
Diesel engineDrives the alternator; runs only in an emergency and during test runs.Leaking hoses, perished V-belts, stale fuel in the day tank.
AlternatorConverts the rotation into electricity; connected to the engine via a coupling.Bearing damage, misalignment between engine and alternator, contamination.
Base frame and vibration dampersCarry engine and alternator, keep vibrations away from the building.Settled or cracked dampers, loosened anchoring.
RadiatorCooler that releases the engine heat to the ambient air via fans.Leaks in the cooling fins, clogged fins, fan bearings.
Exhaust systemManifold, SCR system and silencer carry the exhaust gas outside, cleaned and quiet.Leaking flanges, loose expansion joints, condensate in the run.
Fuel supplyBulk tank in the pit, day tank at the genset, pumps and lines.Water in the diesel, leaking connections, level sensors.
Ventilation and controlsSupply and exhaust air louvres, control cabinet (AMF panel) with starter battery and mains monitoringSticking louvres, weak battery – checked by the qualified electrician.
Technical drawing of a genset in side view: radiator with fan, diesel engine, coupling and alternator on a common base frame with anti-vibration mounts, exhaust system with manifold, SCR and silencer, day tank and control cabinet
Engine, alternator, cooling, exhaust, fuel and controls only deliver power together. Graphic: Omega Mounting

Two things stand apart: the bulk tank and the load bank. The bulk tank holds the reserve for days; the day tank at the genset is refilled from it. The load bank is not part of the system but its test equipment: it simulates the electrical load of the servers so the alternator can be tested at full load without putting the data center at risk.

How does the start sequence run on mains failure?

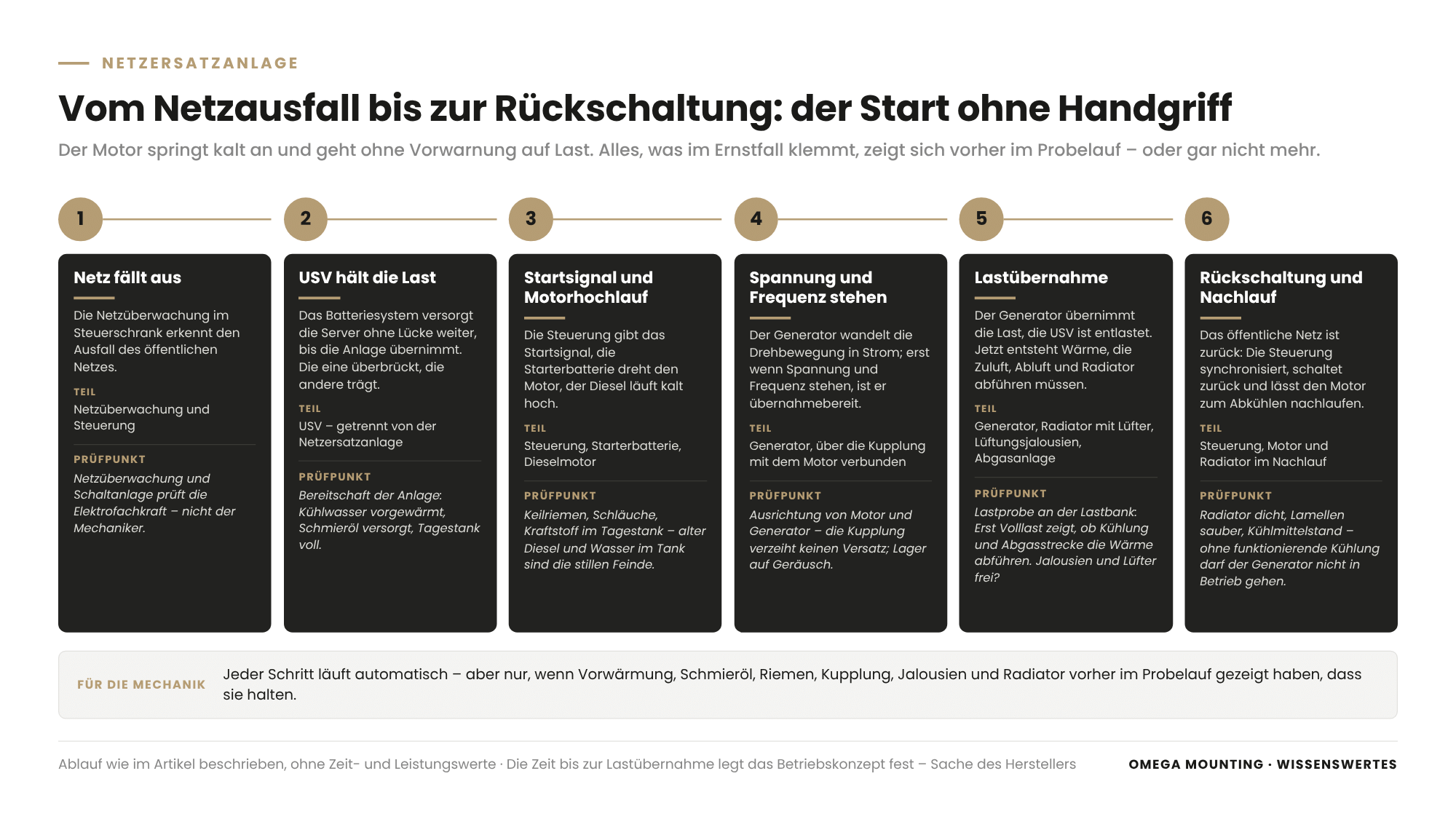

Explanatory graphic: start sequence of a standby power system from mains failure via UPS, start signal and engine run-up, voltage and frequency, load transfer through to return to mains with cool-down run – for each step the working part and a checkpoint
Six steps, all automatic: the controls run the start, and the mechanics have to withstand it without warning. Graphic: Omega Mounting

The start runs automatically. The mains monitoring detects the failure, the controls give the start signal and the engine runs up. As soon as voltage and frequency are stable, the automatic transfer switch (ATS) transfers the load to the alternator; until then the UPS keeps the servers running. When the public grid returns, the controls synchronise, switch back to mains and let the engine run on to cool down.

For the mechanics this means: the engine starts cold and goes onto load without warming up. That is why coolant pre-heating, lubricating oil supply and a full day tank keep the system ready. Anything that sticks in an emergency – an exhaust air louvre, a fan, a valve – shows up beforehand in the test run or not at all.

How much time may elapse between failure and load transfer is defined by the operating concept – that is a matter for the controls and therefore for the manufacturer.

Container or plant room: where does the standby power system stand?

A standby power system stands either as a containerised unit outdoors or as an indoor unit in the generator room. This decision determines the installation route, the installation and every later overhaul.

Characteristiccontainer solutionindoor solution
As deliveredComplete in its enclosure, piped and wired at the factory.Individual modules, installed on site
Move-inOne lift, often as a tandem lift with two mobile cranes; our heaviest containerised unit weighed 54 tonnes.Modules one by one through a façade opening or installation shaft; the heaviest single component, the alternator, weighed just over 20 tonnes
Space requiredOutdoor hardstanding with access, distance from neighbours because of noise.Generator room with supply air, exhaust air, exhaust route and maintenance aisles.
Cooling and exhaustRadiator and silencer in or on the container.Radiator on the façade or on the roof, exhaust run through the building.
OverhaulOpen the container, replace components from outside.Way back out through the installation shaft, enclosure to be dismantled first.
Technical drawing comparing a containerised genset, piped at the factory with the radiator on the roof and moved in with one lift, and a generator room on an upper floor with louvres, exhaust route through the building and a façade opening for the assemblies
The container goes in with one lift – in the building the assemblies arrive one by one through the façade opening. Graphic: Omega Mounting

In data centers, floor space often decides: in the city there is no room in front of the building, so the generators move to the first or second floor. Which crane brings such a load to a height of around 16 metres is explained in our article Mobile crane, crawler crane, all-terrain crane.

What is mechanically maintained on a standby power system?

Mechanical maintenance covers the engine, cooling system, exhaust system, fuel system and bearings – always with the aim that the next start succeeds without a fault. This includes:

Technical drawing of a load test: bulk tank in a pit, pump filling the day tank at the genset, genset running at full load and feeding a load bank that simulates the server load and removes the heat through fans
Only at full load does it show whether cooling and exhaust remove the heat – the load bank simulates the server load. Graphic: Omega Mounting

Starter battery, mains monitoring and switchgear are checked by the qualified electrician, software versions and parameters by the manufacturer. Standby power systems are work equipment within the meaning of the BetrSichV (German Industrial Safety Ordinance), and German water protection law (AwSV) applies to the fuel tanks and bund. Which inspections follow from this for you is something to clarify with your inspector; we do not provide legal advice. How to plan maintenance and test runs is covered in our guide to the maintenance of standby generators.

The leak in the radiator: damaged cooling fins before the repair
No operation without a tight radiator: a leak in the cooling fins shuts down the entire generator.

What we pay attention to

With gensets, the small details decide the programme. This is what we check before the first lift:

Technical drawing of Standby generator with numbered check points: The way back out, Space at the radiator, Alignment, Lift plan, Electric, Pressure test
Way out, radiator space, alignment, lift plan, electric equipment, pressure test. Graphic: Omega Mounting

Where we use it

Standby power systems are one of our focal points in data center construction in the Rhine-Main region. How generators come into the building as containers or as individual modules is shown in our report on more than 60 generators moved in within three years. That maintenance does not only begin after years is shown by the radiator repair in Offenbach: a few days before go-live, a leak appeared in the radiator, which two of our fitters brazed on site and signed off with a pressure test – the same day the generator was ready again. In Raunheim, acting as the appointed person for lifting operations, we lowered five diesel tanks of 100 cubic metres each into their pit for the standby power system of a data center. What we offer around backup power is set out on our page energy and standby power.

More technology explained

Technology explained

The machines that get a standby power system up to the second floor in the first place.

Technology explained

This is how the transformers come into the building next to the standby power system.

Guide

The guide on how to plan test runs, maintenance windows and overhauls.

Do you have questions about how this works on your site?

Do you have questions about how the installation or maintenance of a standby power system works on your site – from the rigging route to the maintenance window? We are the installation partner with our own qualified electricians, alongside the manufacturer and building services. The quickest way is a callback – briefly describe the system, the building and the date.

Free, no-obligation callback

Tobias Schott, managing director of Omega Mounting GmbH, on a construction site in front of scaffolding

About the author

Tobias Schott

Managing director of Omega Mounting GmbH, Rodgau · more than 20 years of hands-on experience in installation and maintenance

A trained mechatronics technician, working in maintenance, servicing and industrial installation since 2004 – first alongside his father, and with Omega Mounting since 2012: from overhead conveyors in Frankfurt to the crane system in a new-build hall. He plans and leads lifting operations as an appointed person (AP) in data centers and on industrial sites in the Rhine-Main region, trains and examines operators of cranes, mobile elevating work platforms and telehandlers, and is a qualified occupational safety specialist. On jobs abroad he is known as the “German Troubleshooter” – the person you call when a site gets stuck. He learned what quality means from his father, not from a manual: Made in Germany as a standard for his own work, not a label. That is why quality comes first at Omega Mounting – ahead of speed and price. The Technology explained articles cover the equipment and techniques his team uses every day: what counts on site is in them – what only appears in the brochure is not.

Frequently asked questions

Yes, both. A containerised unit arrives complete and is set in one lift, often a tandem lift with two mobile cranes – our heaviest weighed 54 tonnes. For an indoor unit we bring the assemblies into the building individually and connect them in the generator room: radiator with pipework, SCR system, manifold and exhaust line, pipes and AdBlue tanks. By arrangement, our qualified electricians make the electrical connection on the system, the operator handles the feed-in to the building network, and the manufacturer the commissioning.

Yes, on the mechanical and logistics side. For load tests we bring load banks and, where needed, hire generators into the data center, position them and remove them afterwards – as on a job in Frankfurt. The L4 functional tests and the L5 integrated systems test (IST) are run by the commissioning team, and only the CxA issues the tags. We make sure the equipment is in place and the routes are clear when the test window opens.

Yes, as a maintenance partner with our own qualified electricians. We take care of the cooling system, belts and bearings, coupling and alignment, exhaust system, fuel system and test runs under load – and, for overhauls, removing the generator through the rigging shaft. The starter battery, mains monitoring and switchgear are checked by a qualified electrician, software and parameters by the manufacturer. That keeps every responsibility clear.
